2022 - Lake Redwood photo by Ben Stoterau

Photo by Ben Stoterau of Lake Redwood.

2024 Year in Review - Legislative Gathering Presentation

RCRCA 2024 Year-In-Review (pdf)

Download

Jennings_Nov_2024 [Autosaved] (pdf)

Download

Highlights of 2023

STAFF

Shawn Wohnoutka, Water Quality Technician - 20 years

Joy Bruns, Office Manager - 13 years

Bill Moldestad,  PE, Contract Engineer - 21 years

Kerry Netzke, Executive Director - 8 years


RCRCA continues to be funded substantially through grant sources relating to water quality.

FY2023 GRANTS

MPCA – WPLMN Amendment (2022-2024) $73,370.83

MDA – Pesticide Monitoring   $ 6,375

MDA & MAWRC -- Discovery Farms (Redwood County)   $ 4,350

State of MN Bonding – Lake Redwood Dredging Project

Remaining State funds ($7.3M) $  -0-

Remaining Local funds ($900,000) $235,148.41

BWSR – Plum Creek Watershed Clean Water Fund Grant  $400,805

Spent $190,627.41

Encumbered $ 76,573.07

BWSR – Pell Creek Watershed Clean Water Fund Grant  $648,075

Spent $336,603.98

 Encumbered $ 28,596.60

BWSR – Cottonwood-Middle Minnesota One Watershed, One Plan (1W1P)

Planning Grant    $253,000

 Spent  $ 61,342.08

*BWSR – Redwood River 1W1P Planning Grant $238,700

 *NEW GRANTS for 2024

SUMMARY OF PLUM CREEK CWF APPROPRIATION

This grant is intended to provide a minimum of 15% to be added to federal 319 funds (60%) awarded specifically to this watershed. A larger cost-share percentage may be used as long as a 25% match (federal and local funds) is achieved by end of the grant.

Goal: 1,470 tons/year of sediment removed  Current: 1,262.90 tons/year

Match Required: $100,201.25 Match To Date: $319,980.84


APPROPRIATION SUMMARY

$ 400,805.00  =  Grant Amount

$ 909,363.76  =  Total Project Costs

$ 190,627.41  =  CWF Grant Expended

$ 319,980.84  =  Landowner Match Provided

$ 692,071.62  =  Federal 319 Funds

$   17,861.01  =  Federal EQIP Funds


Acre-Feet of storage created = 83.828

Tons/Year of Sediment Removed = 1,262.90


Funding - Clean Water Land & Legacy Amendment, Redwood Soil & Water Conservation District

SUMMARY OF PELL CREEK CWF APPROPRIATION

This grant provides up to 75% cost-share specifically to this watershed. If Plum Creek federal 319 funds remain, they may be used on this grant as well.

Goal: 300 tons/year of sediment removed   Current: 470.69 tons/year

Match Required: $162,018.75 Match To Date: $128,807.04


APPROPRIATION SUMMARY

$ 648,075.00  = Grant Amount

$ 474,003.38  = Total Project Costs

$ 336,603.98  = Grant Expended

$ 128,807.04  = Landowner Match Provided

$   18,124.56  = Other Federal Funds


Acre-Feet of storage created = 0.00

Tons/Year of Sediment Removed = 470.69


Funding - Clean Water Land & Legacy Amendment, Redwood Soil & Water Conservation District

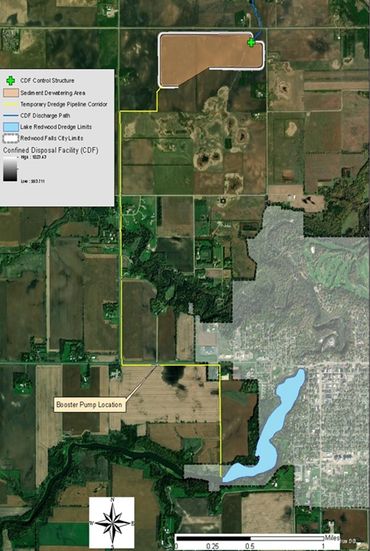

LAKE REDWOOD DREDGING PROJECT UPDATE 2023

► Restoration of unvegetated areas (laydown Area, Confined Disposal Facility (CDF), and other areas)

► Mathiowetz Construction managed the sand pile and internal CDF drainage.

► CDF was seeded aerially by Mulder Air in September.

► CDF ownership will be transferred to the City of Redwood Falls in 2024 for continued management.

► A removable handicap-accessible fishing pier will be installed in 2024 through a DNR cooperative agreement with the City of Redwood Falls.

► Signage will be added to the lake and CDF acknowledging the source of the state funding and map of the lake depths.


Project Partners - Houston Engineering, JF Brennan Company, Mathiowetz Construction, City of Redwood Falls

Highlights of 2022 - Funding Relating to water quality

STAFF:

Shawn Wohnoutka, Water Quality Technician (19 years)

Joy Bruns, Office Manager (12 years)

Bill Moldestad, PE, Contract Engineer (20 years)

Kerry Netzke, Executive Director (7 years)

FY2022 Grants

MPCA – Redwood River TMDL & WRAPS Grant   COMPLETED

MPCA – Cottonwood River TMDL & WRAPS Grant   COMPLETED

MPCA – WPLMN Amendment (2022-2024) $73,370.83

MDA – Pesticide Monitoring   $ 4,850

MDA & MAWRC -- Discovery Farms (Redwood County)  ~$ 3,500

State of MN Bonding – Lake Redwood Dredging Project

Remaining State funds $658,432.91

Remaining Local funds $343,459.90

BWSR – Plum Creek Watershed Clean Water Fund Grant  $400,805 -

Spent $143,735.41 and Encumbered $112,294.54

*BWSR – Pell Creek Watershed Clean Water Fund Grant  $648,075 -

Spent $272,781.53  and Encumbered $66,782.70

*BWSR – Cottonwood-Middle Minnesota One Watershed, One Plan Planning Grant                       ~$253,000

*NEW GRANTS

Summary of Plum Creek CWF Appropriation

This grant is intended to provide a minimum of 15% to be added to federal 319 funds (60%) awarded specifically to this watershed. A larger cost-share percentage may be used as long as a 25% match (federal and local funds) is achieved by end of the grant.

Goal: 1,470 tons/year of sediment removed  - Current: 1,029.60 tons/year

Match Required: $100,201.25  - Match To Date: $434,654.24


Appropriation Summary

Total Project Costs                 =           $596,250.66

Grant Expended                      =           $143,735.41

Landowner Match Provided =           $149,061.92

Federal 319 Funds                   =           $285,592.32


Acred-Feet of storage created     = 71.928

Tons/Year of Sediment Removed = 1,029.60

Summary of Pell Creek CWF Appropriation

This grant provides up to 75% cost-share specifically to this watershed. If Plum Creek federal 319 funds remain, they may be used on this grant as well.

Goal: 300 tons/year of sediment removed   Current: 405.94 tons/year

Match Required: $162,018.75 Match To Date: $96,362.17


Appropriation Summary

Total Project Costs                                         =  $382,352.70

Grant Expended                                                = $272,781.53

Landowner Match Provided                     =  $ 96,362.17

Other Federal Funds                                      =  $  13,209.00


Acre-Feet of storage created           = 0.00

Tons/Year of Sediment Removed = 405.94

Lake Redwood Dredging Project Update - Completed to Date

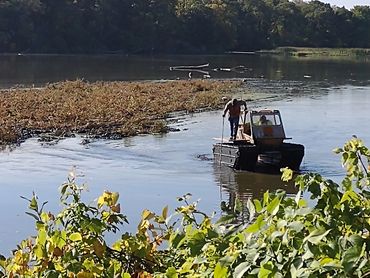

► JF Brennan Company inc. successfully completed dredging the contract quantity of 657,329 cubic yards, PLUS an additional 25,551 cubic yards, for a total of 682,880 cubic yards removed.

►dredging was completed in less than 6 months (April 22 - October 15).

►Brennan has removed all the equipment and pipeline, and with assistance from mathiowetz construction company, will finish restoring all driveways, field approaches and Township roads by Veteran’s Day.

►The project will be completed under budget with local funds returned to the city of redwood falls for CDF maintenance.


Activities For 2023

►Restoration of unvegetated areas (laydown Area, CDF, and any others.)

►CDF will be seeded aerially in the early spring, followed with herbicide.

►Upon project close-out (~ July 1), CDF ownership will be transferred to the City of Redwood Falls for continued management. 5 to 7 years is estimated until the land can be placed into agricultural production once again.

Lake Redwood Reclamation Photos - 2020 & 2021 Highlights

Highlights of 2020 and 2021

FY2020 GRANTS

MPCA – Redwood River TMDL & WRAPS Grant $ 69,000

MPCA – Cottonwood River TMDL & WRAPS Grant $ 66,000

MPCA – WPLMN (Watershed Pollutant Load Monitoring Network) $ 46,800

MDA – Pesticide Monitoring $ 5,500

MDA & MAWRC Discovery Farms (Redwood County) $ 8,000

State of MN Bonding – Lake Redwood Dredging Project $2,005,500


FY2021 GRANTS

MPCA – Redwood River TMDL & WRAPS Grant $ 49,000

MPCA – Cottonwood River TMDL & WRAPS Grant $ 38,000

MPCA – WPLMN (Watershed Pollutant Load Monitoring Network) $50,000

MDA – Pesticide Monitoring $ 5,500

MDA & MAWRC -- Discovery Farms (Redwood County) $ 5,000

State of MN Bonding – Lake Redwood Dredging Project $ 805,000

MPCA – SWAG (Surface Water Assessment Grant) – Yellow Medicine $3,133

BWSR – Plum Creek Watershed Clean Water Fund Grant $ 400,805


SUMMARY OF PLUM CREEK CWF APPROPRIATION

This grant is intended to provide a minimum of 15% to be added to federal 319 funds  (60%) awarded specifically to this watershed. A larger percentage of this grant may be  used as long as a 25% match (federal and local funds) is achieved by the end of the grant. Goal: 1,470 tons/year of sediment removed


COMPLETED PROJECTS:

HOLLY 2 GRADE STABILIZATION – Murray County $ 21,679.89

SPRINGDALE 25 GRASSED WATERWAY – Redwood County $ 9,995.50

SPRINGDALE 13/24 GRADE STABILIZATION – Redwood County $ 29,810.88

SPRINGDALE 13/24 ROAD RETENTION – Redwood County $ 14,071.66

SPRINGDALE 22 WATER & SEDIMENT BASINS (1) – Redwood $ 21,215.70

HOLLY 7 GRADE STABILIZATION – Murray County $ 4,124.00

Total Completed Projects – $ 100,897.63


PROJECTS IN CONSTRUCTION:

SPRINGDALE 22 WATER & SEDIMENT BASINS (2) – Redwood $ 1,978.05 HOLLY 3 GRADE STABILIZATION – Murray County $ 18,537.74

Total Projects in Construction – $ 20,515.79

TOTAL EXPENDITURE TO DATE $ 121,413.42


APPROPRIATION SUMMARY

Total Project Costs = $ 486,949.81

Landowner Match Provided = $ 121,737.21

Federal 319 Funds = $ 225,937.17

Acre-Feet of storage created = 71.928

Tons/Year of Sediment Removed = 201.5+ (updated total not available yet)


UPDATE OF LAKE REDWOOD DREDGING PROJECT

COMPLETED TO DATE

► PROFESSIONAL ENGINEERING PROVIDED BY HOUSTON ENGINEERING INC.

► ALL PERMITS HAVE BEEN RENEWED. LICENSE TO CROSS RAMSEY CREEK IS CURRENTLY AT MNDOT.

► CONSTRUCTION OF THE CONFINED DISPOSAL FACILITY (CDF), OR THE DEWATERING  POND, WAS COMPLETED IN 2020 BY MATHIOWETZ CONSTRUCTION COMPANY.

► JF BRENNAN COMPANY WAS THE SUCCESSFUL LOW BIDDER ($4,468,111.45), COMPETING  WITH 3 OTHER BIDS RANGING FROM $5,889,319.20 TO 8,327,271.68.

► BRENNAN IS CURRENTLY FUSING AND PLACING THE PIPELINE FROM THE LAKE TO THE CDF. THE CDF OUTLET STRUCTURE HAS BEEN SUBMITTED TO DNR FOR APPROVAL, AND  WILL BE PLACED ONCE APPROVED. ALL ANCILLARY OPERATIONS WILL BE COMPLETED  BY YEAR END.

► ONE EASEMENT REMAINS TO BE ACQUIRED AND WILL BE COMPLETED ONCE THE  PIPELINE IS PLACED UPON THE PRIVATE PROPERTY. - 4 - LAKE REDWOOD ACTIVITIES FOR 2022

► AS SOON AS WEATHER PERMITS, JF BRENNAN WILL BEGIN 24/7 DREDGE OPERATIONS.

► DEPENDING UPON THE TIMING OF ICE OUT, THE START OF OPERATIONS MAY BE DELAYED  UNTIL MAY 2022 FOR DOWNSTREAM SPAWNING CONCERNS.

► 650,000 CUBIC YARDS OF SEDIMENT IS THE GOAL FOR REMOVAL.

► DREDGING OPERATIONS WILL BEGIN 100 FEET AWAY FROM THE BRIDGE/DAM AND WILL  PROCEED UPSTREAM. BRENNAN IS CONFIDENT THAT THE GOAL CAN BE ACHIEVED IN  ONE DREDGE SEASON.

► UPON COMPLETION OF DREDGING, THE OWNERSHIP OF THE CDF WILL BE TURNED OVER TO  THE CITY OF REDWOOD FALLS FOR CONTINUED DEWATERING MANAGEMENT. 5 TO 7 YEARS IS THE ESTIMATED TIME FOR COMPLETE DEWATERING, WHICH IS LARGELY  DETERMINED BY THE AMOUNT OF ORGANICS IN THE SEDIMENTS.

► THE CDF BERMS WILL REMAIN PERMANENTLY. THE CITY OF REDWOOD FALLS INTENDS   TO LEASE THE PROPERTY FOR FARMING ONCE COMPLETED DEWATERED

Lake Redwood Activities for 2022

► AS SOON AS WEATHER PERMITS, JF BRENNAN WILL BEGIN 24/7 DREDGE OPERATIONS.

► DEPENDING UPON THE TIMING OF ICE OUT, THE START OF OPERATIONS MAY BE DELAYED  UNTIL MAY 2022 FOR DOWNSTREAM SPAWNING CONCERNS.

► 650,000 CUBIC YARDS OF SEDIMENT IS THE GOAL FOR REMOVAL.

► DREDGING OPERATIONS WILL BEGIN 100 FEET AWAY FROM THE BRIDGE/DAM AND WILL  PROCEED UPSTREAM. BRENNAN IS CONFIDENT THAT THE GOAL CAN BE ACHIEVED IN  ONE DREDGE SEASON.

► UPON COMPLETION OF DREDGING, THE OWNERSHIP OF THE CDF WILL BE TURNED OVER TO  THE CITY OF REDWOOD FALLS FOR CONTINUED DEWATERING MANAGEMENT. 5 TO 7 YEARS IS THE ESTIMATED TIME FOR COMPLETE DEWATERING, WHICH IS LARGELY  DETERMINED BY THE AMOUNT OF ORGANICS IN THE SEDIMENTS.

► THE CDF BERMS WILL REMAIN PERMANENTLY. THE CITY OF REDWOOD FALLS INTENDS TO LEASE THE PROPERTY FOR FARMING ONCE COMPLETED DEWATERED

Power Point Presentations from previous years

RCRCA_2019_Year-In-Review (pdf)Download
RCRCA-2018-Year-In-Review (pdf)Download
RCRCA-2017-Year-In-Review (pptx)Download

Copyright © 2022 rcrca.com - All Rights Reserved.
